Building 5



Regime 56, Building 5

262 S. Sea Pines Dr.

Hilton Head Island, SC 29928

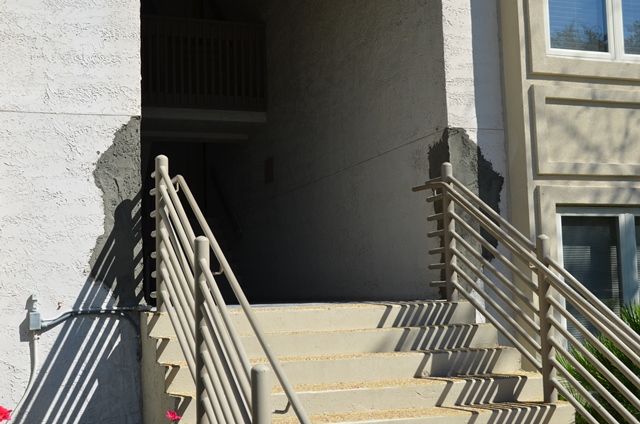

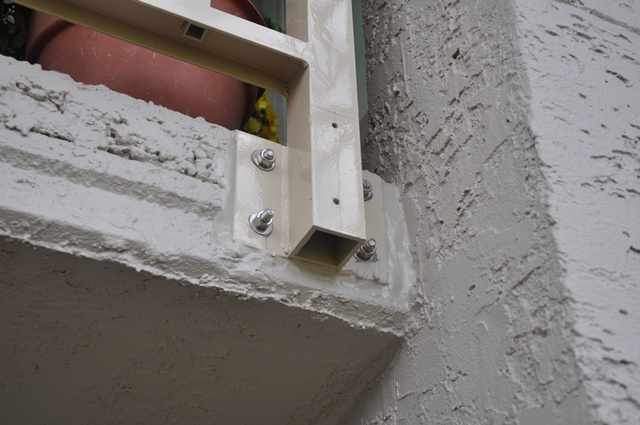

 06/25/2010 Update:

     Balcony handrail replacement on building 5 completed on 06/24/2010, Town inspection scheduled for Monday, June 28, 2010.




06/25/2010 Update:

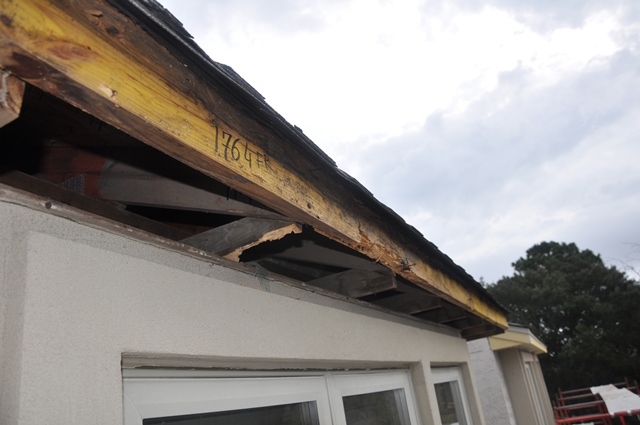

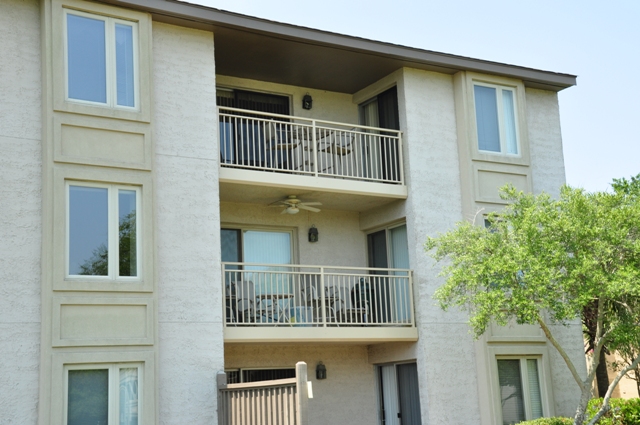

     New balcony Handrails installed on units 1764 & 1756.


     New balcony handrails installed on units 1765 & 1757.

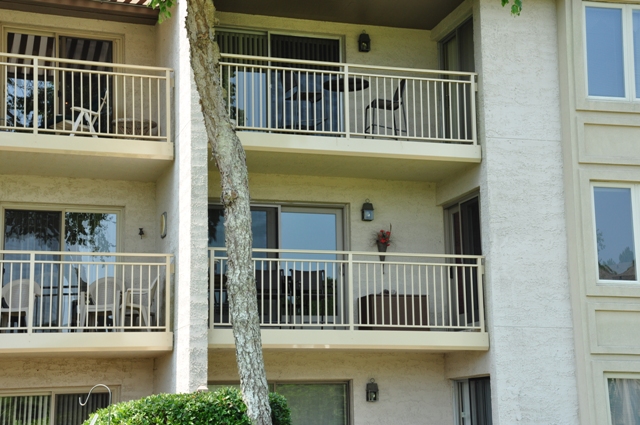

     New balcony handrails installed on units 1763 & 1755.

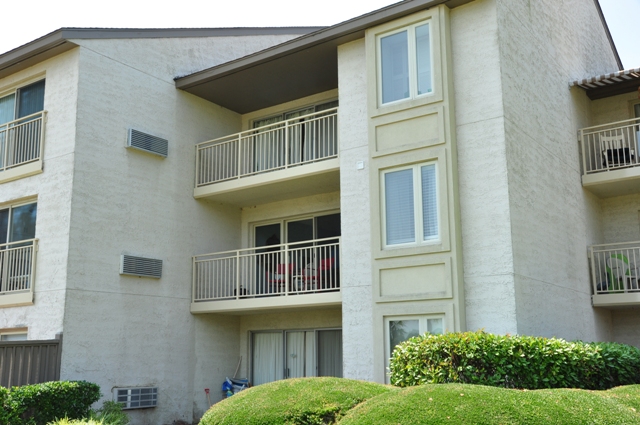

     New balcony handrails installed on units 1766 & 1758.


06/22/2010 Update:

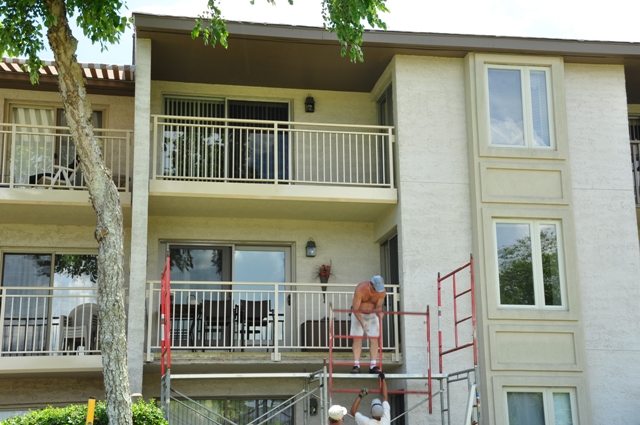

     New balcony handrails installed on units 1763 & 1755. Waiting on fascia delivery for unit 1755.

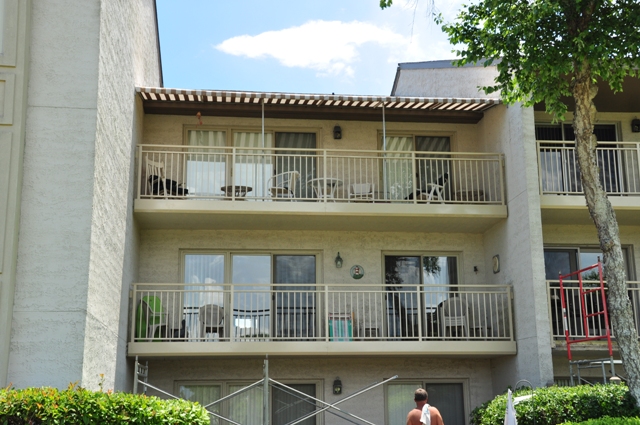

     New balcony handrails installed on units 1762 & 1754. New braces instaled for fabric awning at unit 1762.

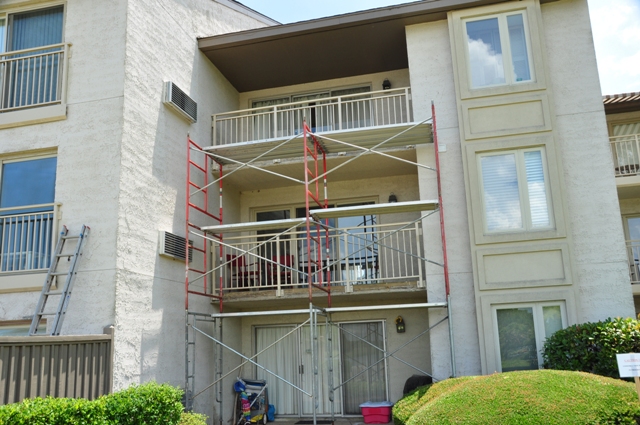

     New balcony handrails installed on units  1766 & 1758. Waiting for fascia delivery.




06/21/2010 Update:

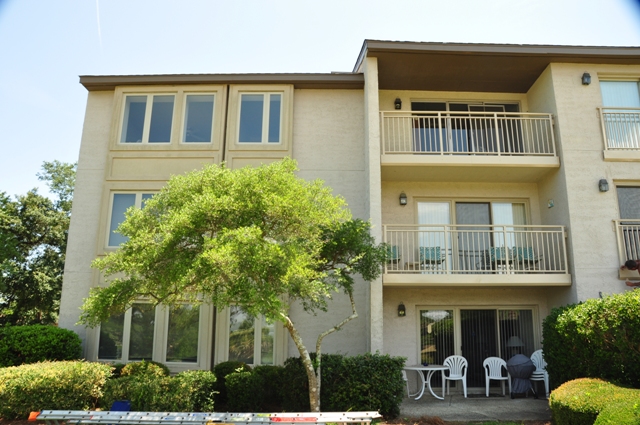

     New balcony handrails installed on units 1769 & 1761.

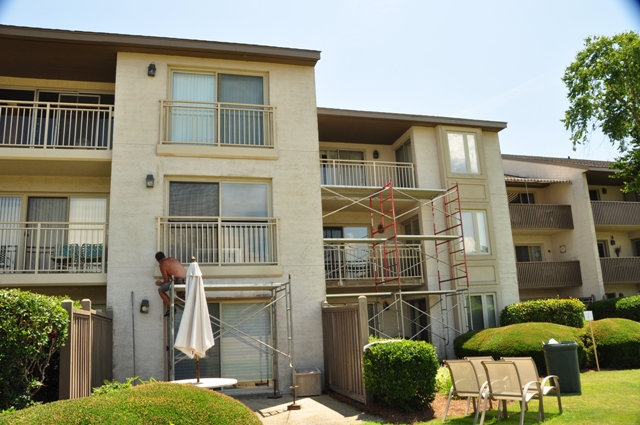

     New balcony handrails installed on units 1767 & 1759. Handrail replacement in progress on units 1766 & 1758.




06/18/2010 Update:

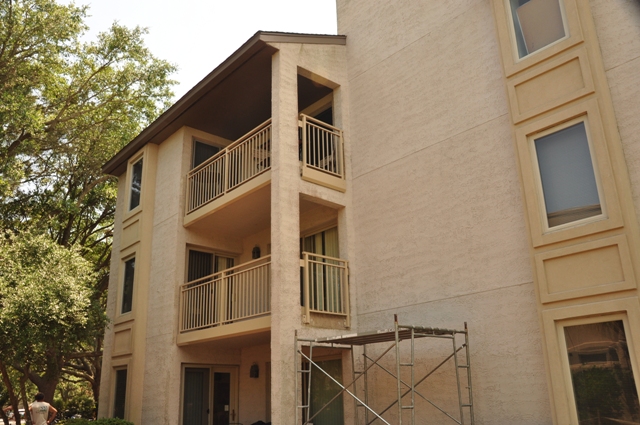

     Balcony handrail replacement started on Friday, June 18, 2010 on Building 5. New, aluminum, powder coated handrails installed on balconies of Units 1760 (second floor) and 1768 (thrid floor). Handrail replacement work will continue on Monday, June 21-st, 2010 on units 1761 and 1769.

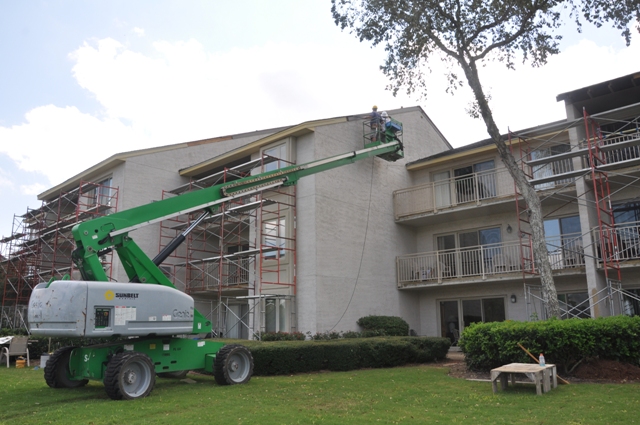

06/07/2010 Handrail Replacement: New handrail installation on Building #5 should start on June 18-th., 2010 and complete on June 25, 2010. For updated project schedules please use a link on the right side menu to "Maintenance Calendar".

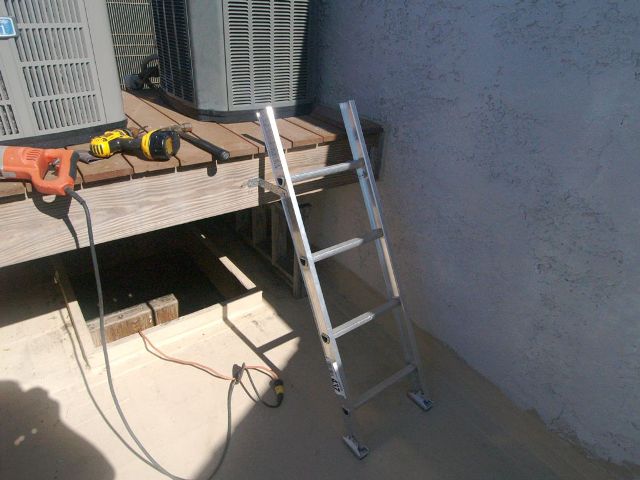

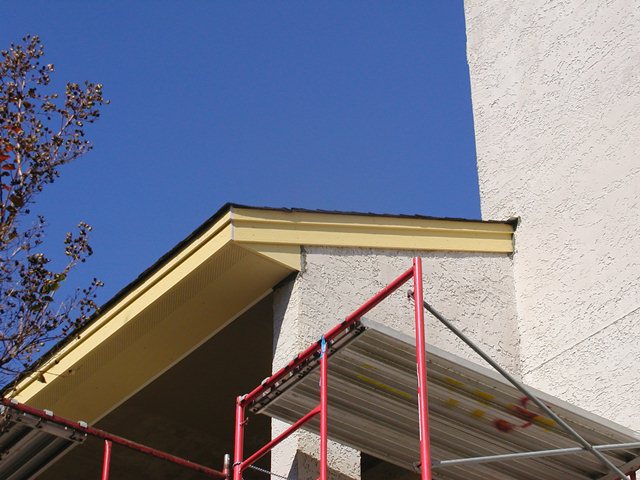

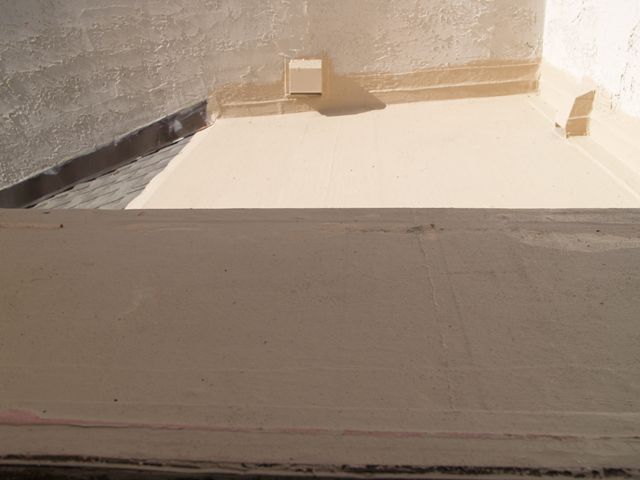

04/20/2010 Aluminum laders installation on the flat roof.

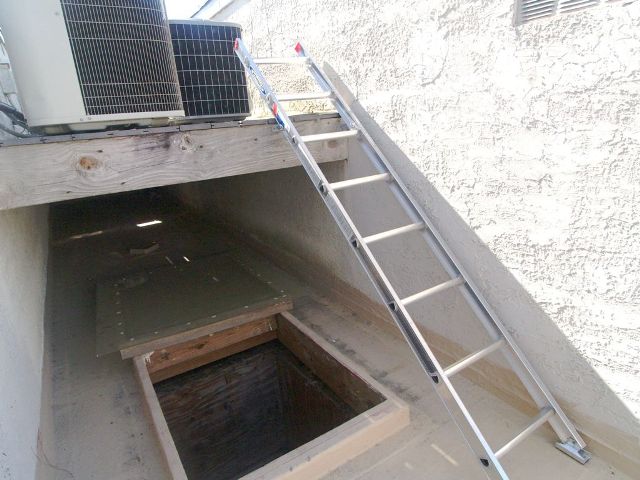

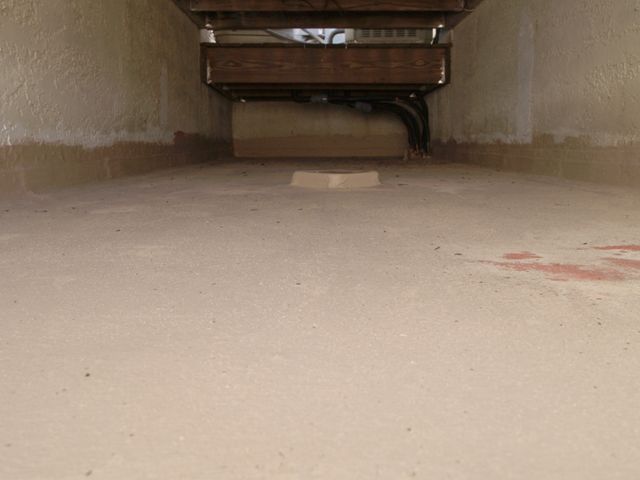

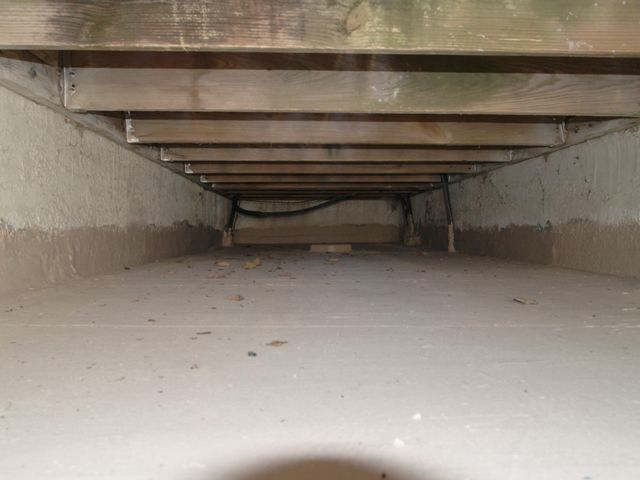

Left side heat pump deck:


Right side heat pump deck:

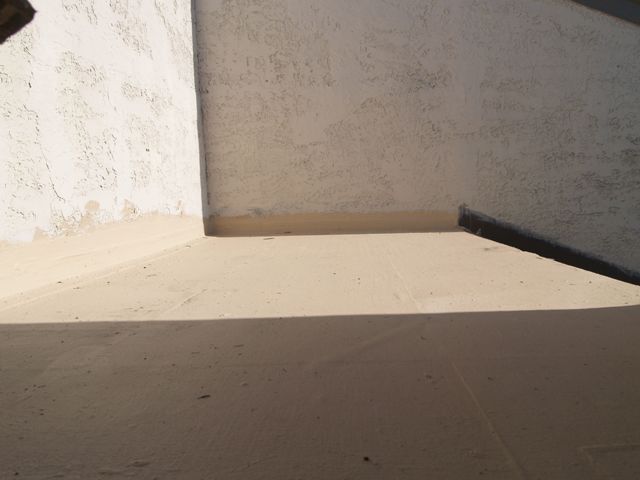

12/20/2009 Final picture of the flat roof deck. Building #5

Final pictures of the flat roof deck on the left side of building #5



Final pictures of the flat roof deck on the right side of building #5

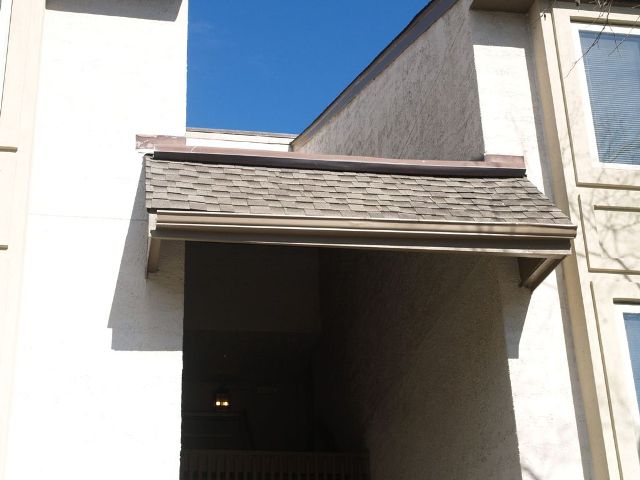

12/15/2009 Sagged roof repair over the left side entry of building 5.

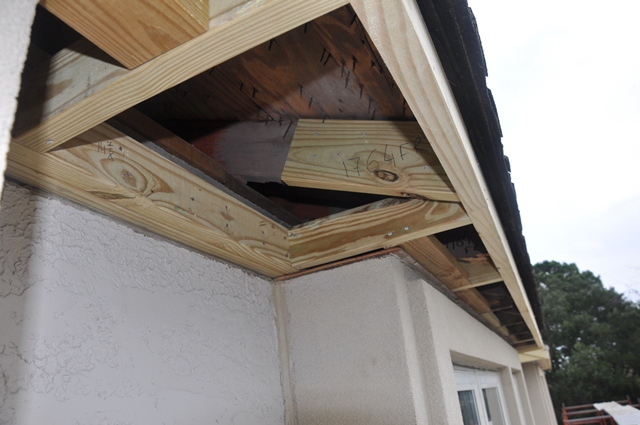

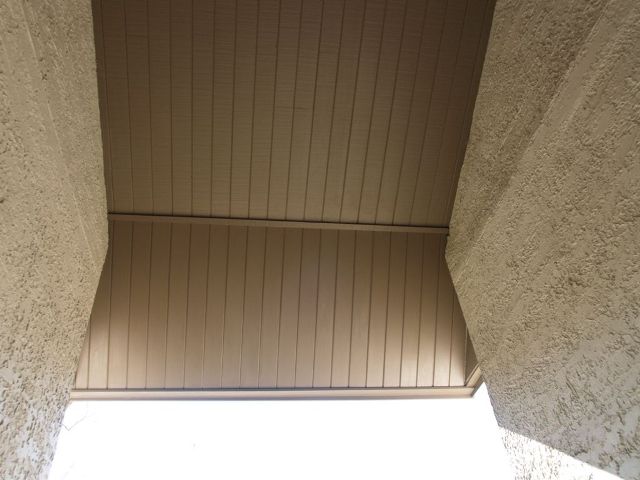

Install fascia board and fascia trim. Install new select cypress 1x6 T&G ceiling boards. Re install rain gutter after paint work.



12/14/2009 Sagged roof repair over the left side entry of Building 5.

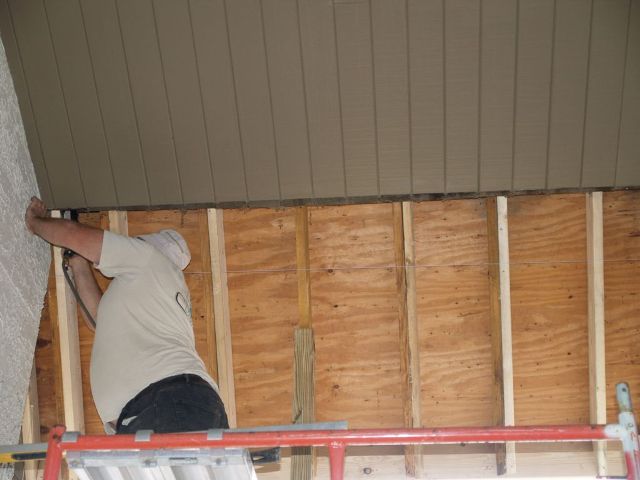

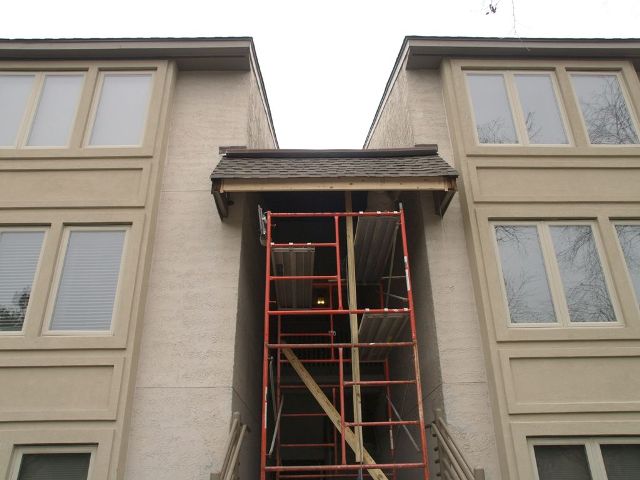

Set up scaffolding. Secure top ends of the rafters using metal angles. Brace bottom part of the rafters. Remove rain gutter, remove fascia board. Jack up sagged part of the roof.

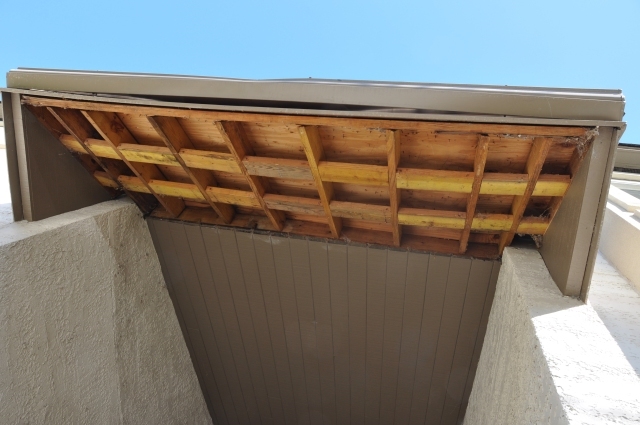

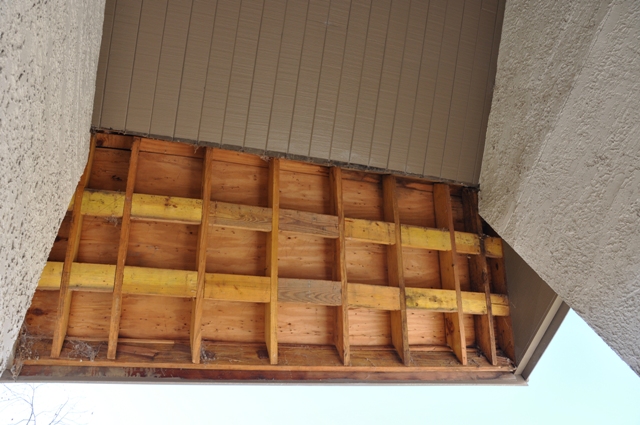

12/01/2009 Sagged roof inspection over the left side entry to Building 5:

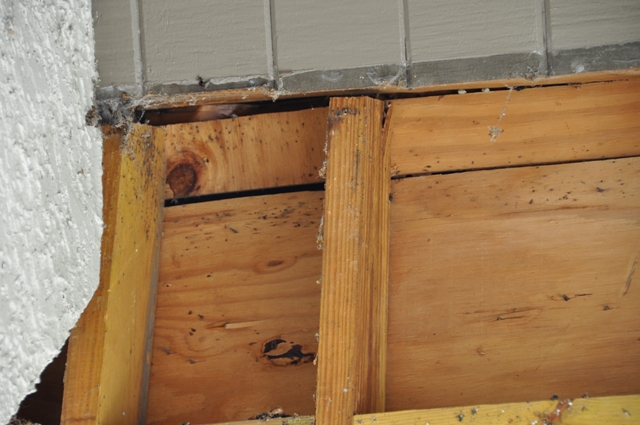

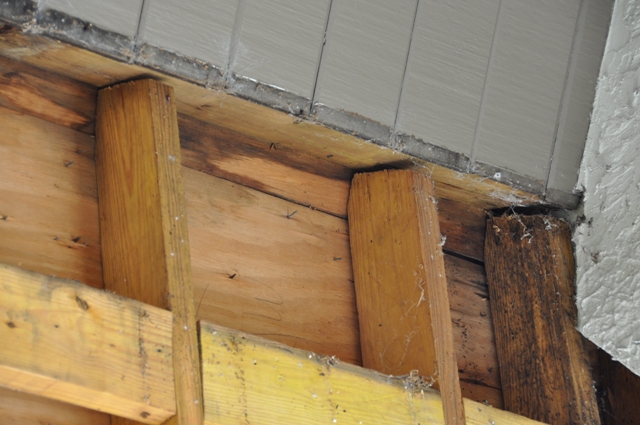

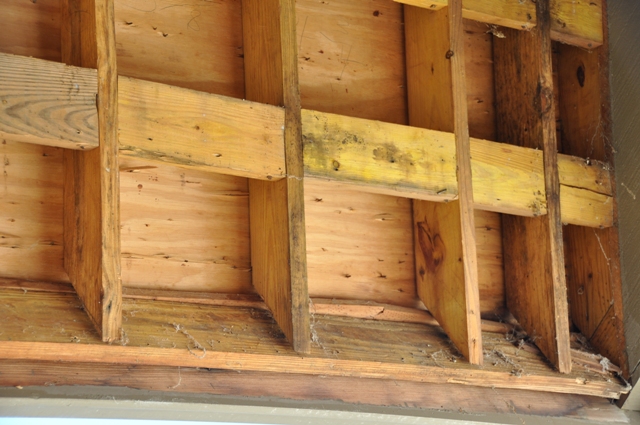

     Sagged roo over the left side entry of building 5 was inspected by EURO Construction, Inc. on December 1-st., 2009 by removing ceiling boards from lower section of entry roof. Only minor moisture damage to the fascia board was found during the inspection.


      Main reason why roof sag took place, was determined to be poor quality original construction. There is a clear evidence of failed nailing attachement between 2x6 rafters and fascia boards on top and bottom part of the roof.


Large gaps exist between rafter ends and bottom fascia board. No anchoring devices, such as clips, metal angles, were installed at the time of original construction. Unrestricted condition of the main elements of the roof framing, caused movement of the framing parts and resulted in roof sag.


     Same condition exist at the top section of the subject roof. Rafters were installed using toe nailing connection to the top fascia board. Due to the dimensional changes in the wood properties over extended period of time, nailed connections have partially failed, resulting in unrestricted movement conditions in the lower roof section.


Existing condition of the roof framing may eventually lead to roof structure collapse from the live load on the roof surface.
